Case portfolio summary
Since 2015, we have successfully resolved over 865 cases across the entire judicial system in Hong Kong, including:
1.Local court dispute
– Claim for property damage
– Breach of contract dispute
– Construction liability case
2.Small Claims Court and Resolutions
– Conflict between tenant and landlord
– Controversy over excessive renovation fees
– Claim for minor building defects
3.land dispute
– Differences on the boundaries
– Lease compliance issues
Annual case volume: DCCJ cases :2023 | 43 2022 | 24 2021 | 36 2019 | 58 2016-2018 | 265
Highlights:✅ DCCJ The success rate of the case is 92% (2019-2023) ✅ SCTC 78% of disputes are settled before trial ✅ All cases are kept 100% confidential
A Case Example

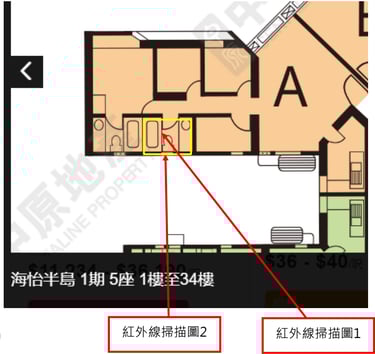

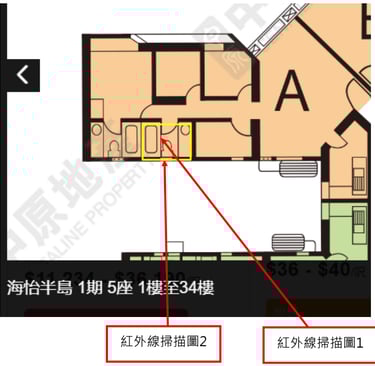

1.Case number:S250423-1P-WL
Detection time:April 23, 2025
一、Problem background

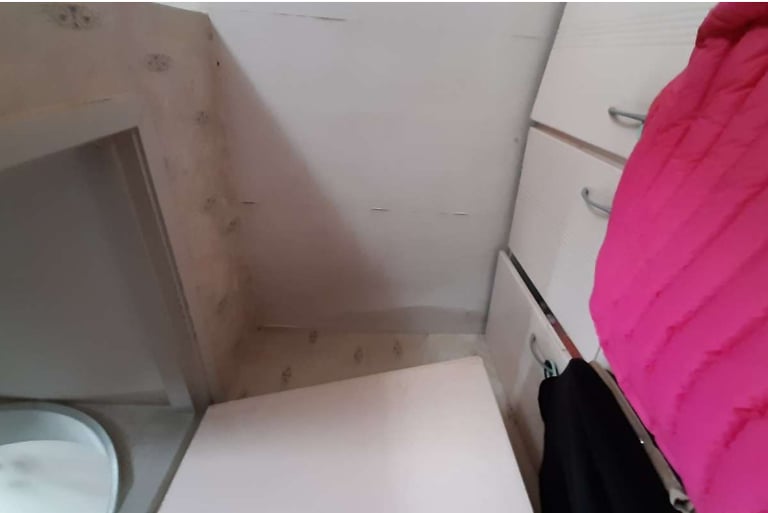

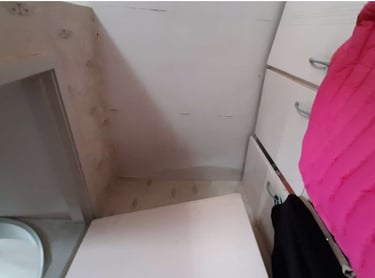

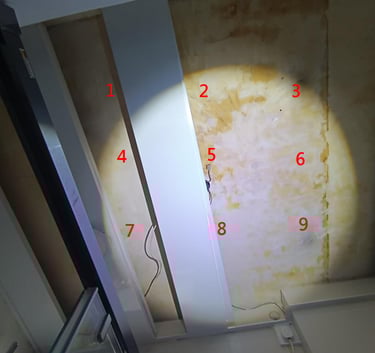

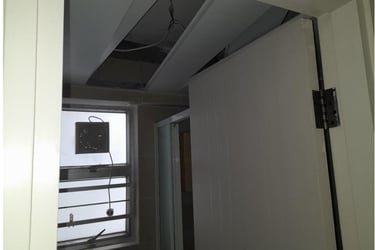

The owner of Room E on the 21st floor of Haiyi Pavilion in Riviera Gardens, Tsuen Wan, New Territories, has discovered severe leakage from the ceiling of the toilet, accompanied by concrete spalling, steel corrosion, and power outages. It is initially suspected that the cause lies in the renovation works of the upper-level unit, and the responsibility needs to be clarified.
二、Detection methods and technological applications
1.High-definition infrared scanning

Using a Fluke infrared scanner, locate water-hidden areas through temperature differences.

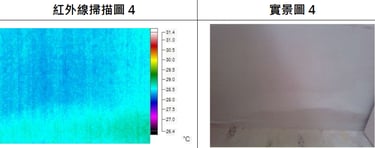

The low temperature zone (blue/purple) indicates the presence of extensive water accumulation beneath the floor of the upper unit's toilet.
2.Conductive induction humidity detection
The humidity at the critical point reached 99.9% (with a normal value of less than 20%), confirming persistent leakage.
The humidity distribution map clearly indicates that the source is the floor of the upper toilet.

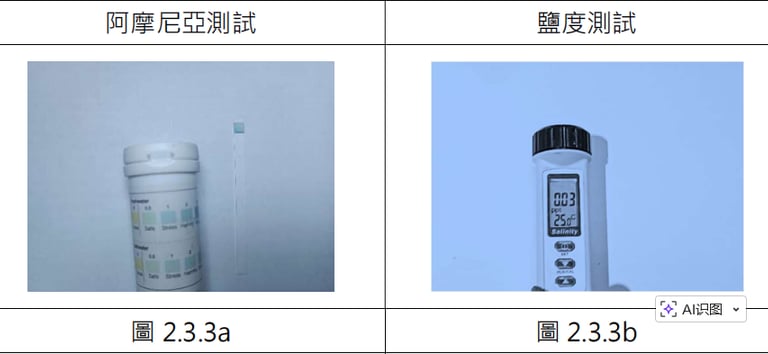

3.Chemical analysis of water samples
The positive reaction to ammonia and the detection of salt content (0.04 p.p.t) ruled out rainwater on the external wall and confirmed a leak in the drainage pipe.
三、Key evidence and conclusions
1.Responsibility attribution: The waterproof layer of the toilet in the upper unit failed, and the accumulated water penetrated into the lower unit through cracks in the floor.

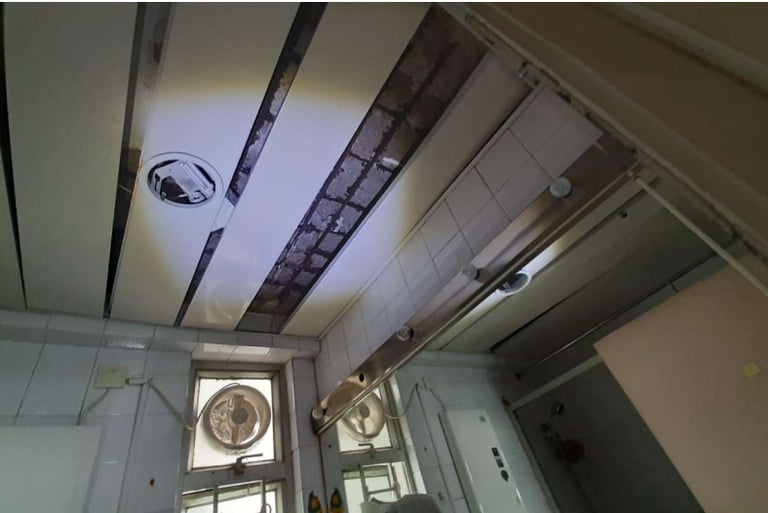

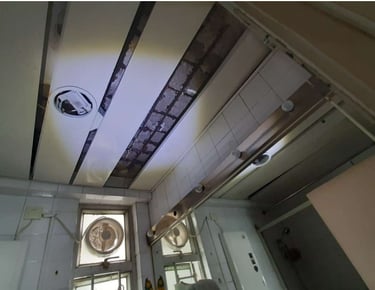

2.Structural risk: The reinforcement in the lower ceiling has corroded to a severe level, and the concrete is hollow and requires urgent repair.
3.Legal effect: The report complies with Appendix E of the Rules of the District Court and is accepted by the High Court of Hong Kong.
四、Maintenance suggestions and cost assessment
1.Emergency works: demolish damaged structures, replace steel bars, and redo the waterproof layer.
2.Cost Estimation: HKD $46,455 (based on the government's wage standard for 2025).
3.Achievements: Assisted the client in fully recovering compensation and avoiding litigation costs.
Expert statement
Report written and endorsed by authorised expert (master of building surveying, chartered building surveyor, chartered building engineer and chartered builder) .
The inspection strictly adheres to the technical standards set by the Hong Kong Architectural Services Department and the Buildings Department.
2.Case number:S240227-1J-WL
Detection time:February 27, 2024
一、Problem background

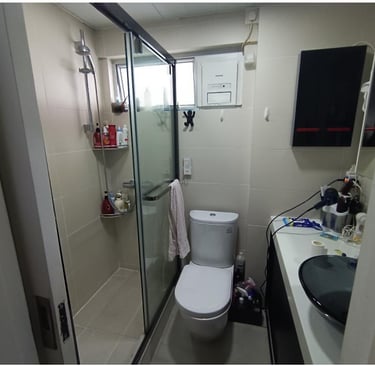

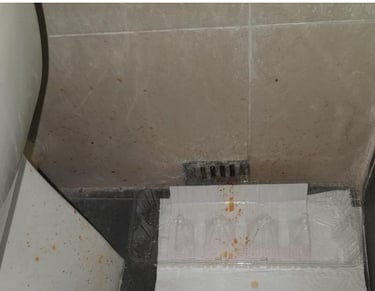

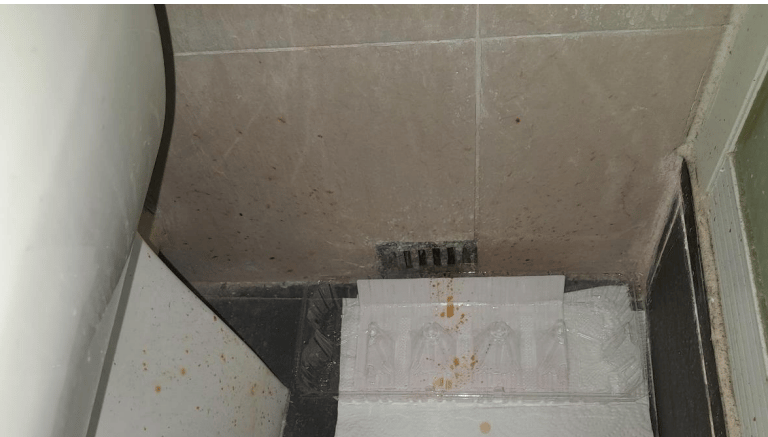

The owner of Unit A on the 29th floor of Haining Pavilion, Block 5, Phase 1 of Haiyi Peninsula in Ap Lei Chau discovered continuous leakage from the ceiling of the guest bathroom, water stains on the walls, and water droplets hanging from the electrical fixtures. The customer had previously negotiated with the unit above (Unit A on the 30th floor) regarding the leakage issue, but it was necessary to clarify the attribution of responsibility and the source of the leakage.
Note: There are obvious water stains and damp traces on the ceiling at the affected location
二、Detection methods and technological applications
1.High-definition infrared scanning

Using a Fluke infrared scanner for inspection, a large low-temperature area (blue/purple) was discovered beneath the washbasin/bathtub in the guest bathroom on the upper floor, indicating concentrated water accumulation.
2.Conductive induction humidity detection
The humidity at the critical point reached 45.3% (normal value < 20%), confirming continuous leakage.
The humidity distribution map indicates that the leakage source is concentrated on the floor of the upper guest toilet.
3.Chemical analysis of water samples
The positive reaction to ammonia and a salt content of 0.06 p.p.t. ruled out rainwater on the external walls, confirming that the issue was due to internal pipe leakage.
三、Key evidence and conclusions
1.Responsibility attribution: The waterproof layer of the guest toilet on the upper floor failed, causing water to seep through the floor and into the lower floor.
2.Risk assessment: The risk of corrosion of steel reinforcement in the ceiling is high, and urgent maintenance is required to prevent concrete spalling.
3.Legal effect: The report complies with Appendix E of the Rules of the District Court and is accepted by the High Court of Hong Kong.
四、Maintenance suggestions and cost assessment

1.Emergency works: removal of damaged ceilings, rust prevention treatment, re-installation of waterproofing layer, and inspection of electrical system.
2.Cost Estimation: HKD $27,275 (based on the government's wage standard for 2023).
3.Effectiveness: Assisted the client in clarifying responsibilities and facilitated the upper-level unit in bearing the maintenance costs.
Expert statement
Report written and endorsed by authorised expert (master of building surveying, chartered building surveyor, chartered building engineer and chartered builder).
The inspection strictly adheres to the technical standards set by the Hong Kong Architectural Services Department and the Buildings Department.
3.Case number:S230228-1A-WL
Detection time:February 28, 2024
一、Problem background

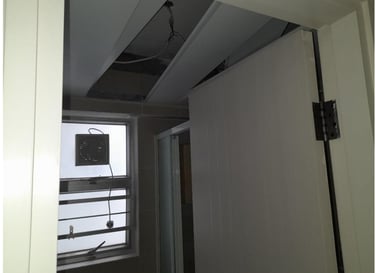

The owner of Room A on the 4th floor of Building 10, Jintao Garden, Phase 2, Whampoa Garden, Hung Hom, Kowloon, discovered continuous leakage from the ceiling of the toilet. As the unit above (Room A on the 5th floor) is undergoing renovation, it is necessary to clarify the responsibility for the leakage. The client entrusted Yinjin Notary Public to conduct a systematic inspection to pinpoint the source of the leakage with scientific data.
二、Innovative detection methods and technology applications
This inspection adopts a six-stage systematic testing approach, covering water supply pipes, drainage facilities, and waterproof layers:
1.Fresh water pipe switch test (comparing changes in leakage data)
2.Fluorescent tracer tracking test (using four-color fluorescent agents to distinguish different water sources):
Green: waterproof layer of the cylinder
Blue: toilet flushing
Red: Water drainage for the washbasin
Orange: floor drainage
三、Key evidence and conclusions
1.Infrared scanning data comparison

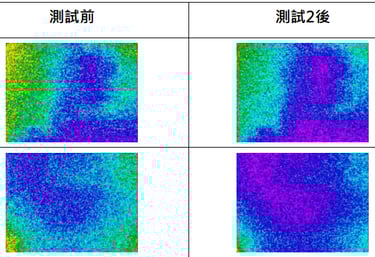

After Test 2 (cylinder waterproof layer): The water-holding area significantly expanded, and the low-temperature zone (blue/purple) spread
The remaining tests did not trigger any significant changes, ruling out the possibility of other water sources
2. Quantitative analysis of humidity data
After Test 2, the humidity at the key point soared: the humidity at Location 3 increased from 46.4% to 57.5% (an increase of 11.1%)
The remaining tests showed a humidity fluctuation range of less than 3%, confirming that the leakage source is concentrated in the cylinder area
3. Chemical indicators of water samples

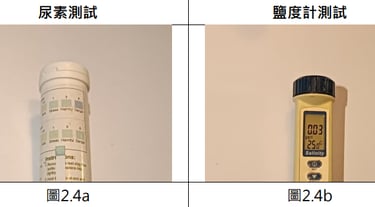

Positive reaction to urea + salt content of 0.03 p.p.t., confirmed as sewage leakage
Based on the fluorescence test results, the factor of rainwater on the exterior wall is ruled out
四、Expert conclusions and maintenance suggestions
1.Responsibility identification:
The failure of the waterproof layer on the floor and walls of the upper unit's enterprise cylinder led to sewage infiltration
2.maintenance schedule:
Re-do the waterproof layer of the enterprise cylinder (it needs to meet the standard of being 1.8 meters above the ground)
Repair the structural damage of the lower ceiling
3.Technical Highlights:
Multicolor fluorescent tracer technology precisely distinguishes potential water sources
The six-stage testing method eliminates interfering factors and enhances the credibility of evidence
Legal effect
Report written and endorsed by authorised expert (master of building surveying, chartered building surveyor, chartered building engineer and chartered builder)
The testing method complies with Appendix E of the Rules of the District Court, Cap. 336H, Laws of Hong Kong
